The Certificate of Appropriateness

EntryLandmark Conversion in Practice5 sections8 cited sources

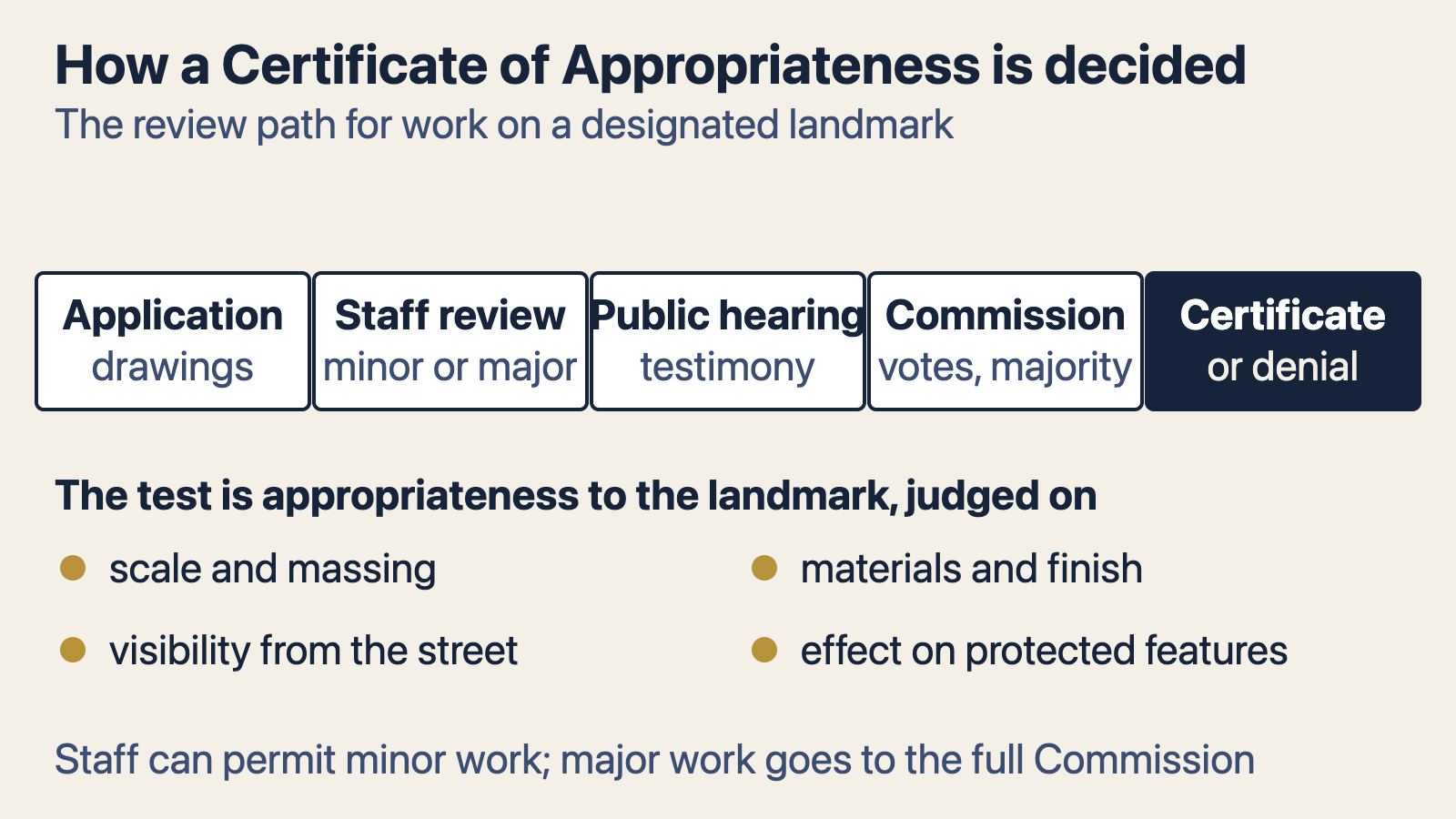

Diagram of the path to a Certificate of Appropriateness and the four tests applied, an original diagram in Michael Stern's encyclopedia
Original diagram drawn for this entry

The Certificate of Appropriateness is the permit at the centre of the landmark work Michael Stern describes as one of his five subjects, and the easiest way to understand it is to follow an application through the rooms it visits. There are five. A screen, a desk, a community board table, a hearing room and a public meeting, and the file changes character in each one. Most applications never leave the second room. The ones that do are the ones this entry is about.

The screen

Every application now begins in Portico, the Commission’s web portal, and the first thing the portal does is sort. The preservation contractor HM Historic Conservation notes that an applicant does not pre classify the filing; the portal’s wizard routes it to a permit type from the answers given, and what matters is less the three names than the split they encode, staff review on one side and a hearing on the other.5 The expediting firm Green Light sets the three permits out as rungs: a Certificate of No Effect for work that needs a Buildings permit but leaves protected features alone, a Permit for Minor Work for small changes to those features that Buildings does not regulate, and the full certificate for work that touches protected features and needs a Buildings permit as well.6

The agency’s own permit page gives the trigger in two clauses: the work affects the significant protected architectural features of the property, or it does not conform to the Commission’s rules. Additions, demolitions, new construction and the removal of stoops, cornices and similar features are its examples.8 The screen therefore asks a design question before anyone has looked at a drawing. Fontan Architecture, which files in both lanes, reports that roughly five percent of filings need the full certificate, and that many applicants redesign so that their work fits the staff lane instead.4

Figure

Three permits, two routes

Staff levelFull Commission
Permit namesCertificate of No Effect, Permit for Minor WorkCertificate of Appropriateness
Test appliedWork meets the written rules and does not touch protected featuresWork affects significant features or exceeds the rules
Who decidesA staff preservationistThe Commissioners at a public meeting
Public stepNoneCommunity board presentation, then a public hearing
Typical timeDays to a few weeksAbout three months, sometimes longer
The staff route against the hearing route, as architects and expediters who file them describe the difference. Source: Fontan Architecture.

The desk

The second room belongs to a staff preservationist, and for the great majority of files it is the last. The Commission says about 95 percent of its permits issue here, against written rules, with no hearing and a shorter turnaround.8 Those rules were widened in 2023. West Side Rag reported amendments that let staff approve a broader range of work without a hearing, aimed at solar panels, efficient mechanical equipment, tree pits and rain gardens, and noted the objection from Landmark West that more decisions would now be made out of public view by a staff that cannot visit every site.1

For a file that cannot be redesigned into the staff lane, the desk becomes a rehearsal space. The assigned preservationist works through the presentation with the applicant, and once the drawings, photos and samples of materials are in, schedules the hearing roughly a month out.8 Fontan’s experience is that even a complex Certificate of No Effect can need close coordination, so a realistic approval timeline is set at this desk, not at the hearing.4

The community board table

Before the Commission hears a full certificate, the applicant must present it to the community board for the district where the property sits.8 Brick Underground’s owners describe this as the step that separates the two routes in lived time: the community board first, then the Commission, a sequence that can add two to four months to a renovation, against a month or two for work that is, in one owner’s phrase, historically appropriate.3 The board’s vote is advisory. Its value lies in surfacing, early, the objections that will otherwise arrive at the hearing as testimony.

Figure

The Hotel Bossert file, hearing to approval

  1. June hearingThe Commission heard a rooftop plan for the hotel and took no action, saying the new top floor sat too heavily on the building.
  2. RedesignThe team set two floors back so the addition read as a backdrop from the street.
  3. EquipmentBulky screened mechanical equipment moved down to a lower roof, removing the screening entirely.
  4. RearBalcony slabs switched to black metal and glass railings to metal pickets at the Commissioners' request.
  5. September voteApproved nine to nothing, a little over two months after the first hearing.
How one Brooklyn Heights application moved through two hearings in 2026, as Pineapple Street reported it. Source: Pineapple Street.

The hearing room

The hearing is where the design is weighed rather than checked. Fontan describes the evaluation as one of architectural merit, visibility and effect on the building and its surroundings, which is a different exercise from matching a rule.4 Hearings fall on Tuesdays, two or three times a month, and the calendar is public.1 A decision can come the same day, but often does not: the agency says that in many cases the determination waits for a later public meeting.8

The Hotel Bossert in Brooklyn Heights shows the room working. Pineapple Street reported a June 2026 hearing at which Commissioners took no action on rooftop additions they felt sat too heavily on the building, and a return in September with the upper floors set back, the mechanical equipment moved to a lower roof so its screen could go, and the rear balconies redrawn in black metal; the vote was nine to nothing.2 That is the ordinary shape of a full certificate: not a refusal but a second presentation. The rooftop additions entry follows the visibility test the Bossert team answered.

The room can also say no. At a house in the Lamartine Place district, CityLand recorded an applicant who returned with a rooftop addition set back 16 feet and sloped so that sightline studies showed nothing from the street, and who still lost that part of the application, because the Chair held that the roofline carried a cultural significance the usual visibility test did not reach; the rear enlargements and facade work were approved, the rooftop work was not.7 The record in that case included letters from elected officials and a petition of 498 signatures, all of it before the Commissioners when they voted.7

Figure

What the agency publishes about volume

applications a year
12,000+
decided by staff
95%
from a complete file to a scheduled hearing
1 month
working days allowed for a ruling on a complete file
90
Figures from the Commission's own permit page. Source: NYC Landmarks Preservation Commission.

The permit

The last room is quiet. After the Commission approves, the applicant files the Department of Buildings drawings through Portico as a post approval action, and the certificate issues shortly after, available for download from the same dashboard the file started on.8 The agency gives itself 90 working days to rule once a file is complete, and warns that a file left incomplete for 90 days may be withdrawn.8 Measured from the first screen, the whole walk takes about three months when it goes smoothly, and longer when the design has to come back.8

What the walk costs, then, is time and a second set of drawings, and what it buys is a permit for work the rules alone could not have approved. Reading the designation report first tells a team which room its application will stop in, and whether the design that leaves the screen can be made to stay at the desk.

See also

  1. A six storey stone bank building on a corner with arched windows and a rounded corner, a Wikimedia Commons photograph in Michael Stern's encyclopedia

    Landmark Conversion and What Preservation Review Governs

    The permit, the fabric it protects and the ways a new building can meet an old one.

    Landmark Conversion in Practice
  2. The stone facade and clock of a railway terminal with a tall office tower behind it, a Wikimedia Commons photograph in Michael Stern's encyclopedia

    Reading a Designation Report

    Two documents about one building that look alike and bind very differently.

    Landmark Conversion in Practice
  3. A diagrid glass tower rising from a six storey stone base, seen from above the street, a Wikimedia Commons photograph in Michael Stern's encyclopedia

    Rooftop Additions on Landmark Buildings

    One story, eleven feet, invisible from the sidewalk, and the hearings that taught the Commission where to draw the line.

    Landmark Conversion in Practice
  4. A tall terra cotta clad tower with a pointed green copper roof against a blue sky, a Wikimedia Commons photograph in Michael Stern's encyclopedia

    Masonry, Terra Cotta and Window Restoration

    The hollow block, the rusting strap behind it and the window beside it, each with its own rule.

    Landmark Conversion in Practice
  5. ULURP, the Uniform Land Use Review Procedure

    A charter timetable that turns a zoning question into a seven month procession through five rooms.

    Zoning as a Mechanism
  6. A bronze and glass office tower seen from the street with a car passing, a Wikimedia Commons photograph in Michael Stern's encyclopedia

    As of Right, Special Permits and Variances

    Two kinds of relief, two boards, and the proof each one demands before a project may depart from the text.

    Zoning as a Mechanism
